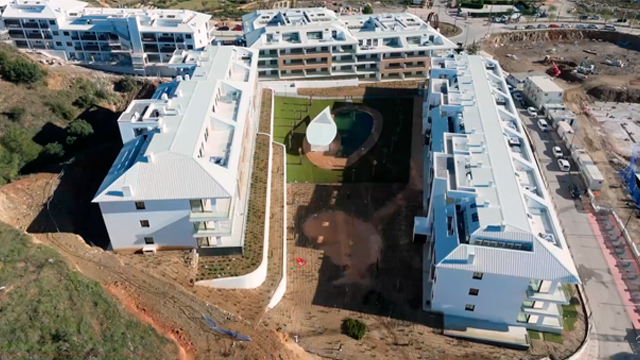

Development progress

Find out
THE DEVELOPMENT STATUS

Check the progress of the Lomas del Higuerón development through the construction progress videos we have prepared for you.

LOMAS 2 PROGRESS

Construction progress
Construction Finished 100%
2024
Construction Finished
November 2024
November

- Finishing of the development and last finishing touches to the common areas.
- Beginning of housing deeds.

2024
Construction Progress
September 2024
September

- Completion of residential development works.
- Completion of blocks 4 and 6.
- Completion of telecommunications installations.
- Start-up of elevators.
- Preparation of dwellings for courtesy visits.

2024
Construction Progress
July 2024
July

- Finishing paths on interior common zones.
- Last touches to the dwellings.
- Exterior fences.
- Interior infrastructures.

2024
Construction Progress
May 2024
May

- Interior partitioning.
- Electricity inside the buildings.
- Flooring and Tiling.
- Roofing.
- Buildings’ external drains and sanitation.
- Electricity jonctions.
- Exterion walls.
- Kitchens.
- Painting and plastering of walls and ceilings.
- Commun zones.

2024
Construction Progress
March 2024
March

- Interior partitioning.
- Exterior drainage.
- Electricity inside the buildings.
- Flooring.
- Painting and plastering of ceilings and walls.
- Interior and exterior servicing and landscaping.
- Roofing.

2024
Construction Progress
January 2024
January

- Interior partitioning.
- Exterior drainage.
- Electricity inside the buildings.
- Flooring.
- Painting and plastering of ceilings and walls.
- Interior and exterior servicing and landscaping.
- Roofing.

2023
Construction Progress
November 2023
November

-Interior partitioning
- Electricity inside the buildings
- Flooring
- Roofing

2023
Construction Progress
September 2023
September

- Installation of interiors.
- Interior urban development works.
- Start of interior carpentries.
- Executing general installations.

2023
Construction Progress
July 2023
July

- Completion of the structure in all the buildings of the development.
- Executing façades in all the blocks.
- Executing roofs in all blocks.
- Executing interior partition walls in all the blocks.
- Executing exterior installations

2023
Construction Progress
May 2023
May

- Executing structure in all blocks of the development.
- Completion of the structure in blocks 1, 2, 3 and 5.
- Carrying out casement enclosure in blocks 1, 2, 3 and 5.
- Installing the metallic structure for the roof of blocks 1, 2, 3 and 5.
- Building the structure in blocks 4, 6, 7 and 8.

2023
Construction Progress
March 2023
March

- Executing concrete structure.
- Façades.
- Beginning of exterior installations.
- Continuing with housing block structures.

LOMAS 3 PROGRESS

Construction progress
Construction Finished 100%
2024
Construction Finished
March 2024
March

- Completion of dwellings finishes.
- Installation of kitchens.
- Perimetral sidewalk of the urbanization.
- Terraces, gardens and common areas.

2024
Construction Progress
January 2024
January

- Completion of dwellings finishes.
- Installation of kitchens.
- Perimeter walls of the complex.
- Terraces, gardens and common areas.

2023
Construction Progress
November 2023
November

- Completion of dwellings finishes
- Installation of kitchens
- Perimeter walls of the complex
- Terraces, gardens and common areas

2023
Construction Progress
September 2023
September

- Finishing façades.
- Sanitary installations.
- Interior urban development works.
- Start of interior carpentries.

2023
Construction Progress
July 2023
July

- Finishing plasterboard
- Installation of sanitary ware
- Executing of walls painting
- Implementation of indoor common areas

2023
Construction Progress
May 2023
May

- Exterior cladding.
- Laying flooring on upper terraces.

2023
Construction Progress
March 2023
March

LOMAS 3: Interior partition walls, interior installations, start of interior carpentry ant start of false ceilings. LOMAS 4: Concrete structure and facades.

2023
Construction Progress
January 2023
January

The masonry of the facades of Lomas 3 is being completed and the structure of Lomas 4 is being built.

2022
Construction Progress
November 2022
November

The dwellings that make up the development are being raised and the interior installations are beginning to be installed.



2022
Construction Progress
September 2022
September

Work on Lomas 3 and Lomas 4 is progressing well, with the structure of the houses being finalised.

2022
Construction Progress
July 2022
July

We are progressing with the execution of the structure of the first floors of Lomas 3 as well as the pillars and base of Lomas 4.

2022
Construction Progress
May 2022
May

The construction of the Lomas 3 and Lomas 4 housing developments has started and is proceeding according to plan.

LOMAS 4 PROGRESS

Construction progress
Construction Finished 100%
2024
Construction Finished
November 2024
November

- Finishing of the development and last finishing touches to the common areas.
- Beginning of housing deeds.

2024
Construction Progress
September 2024
September

- Completion of common areas.
- Review of the condition of the dwellings.


2024
Construction Progress
July 2024
July

- Last touches to common zones.
- Finishing all instalations.


2024
Construction Progress
May 2024
May

- Flooring of common areas.
- Finishing of dwellings.
- Work on installations in dwellings and communal areas.
- Conditioning of the community’s perimeter.

2024
Construction Progress
March 2024
March

- Completion of finishes of the dwellings.
- Installation of kitchens.
- Perimeter walls of the urbanization.
- Perimetral sidewalk of the urbanization.
- Terraces, gardens, and common areas.

2024
Construction Progress
January 2024
January

- Wooden carpentry.
- Completion of finishes of the dwellings.
- Installation of kitchens.
- Perimeter walls of the urbanization.
- Terraces, gardens and common areas.

2023
Construction Progress
November 2023
November

- Wooden carpentry
- Completion of finishes of the dwellings
- Installation of kitchens
- Perimeter walls of the urbanization
- Terraces, gardens and common areas

2023
Construction Progress
September 2023
September

- Starting of façades.
- Installation of interiors.
- Interior urban development works.
- Start of interior carpentries.

2023
Construction Progress
July 2023
July

- Finishing plasterboard
- Installation of sanitary ware
- Execution of painting
- Implementation of indoor common areas

2023
Construction Progress
May 2023
May

- Completed enclosure
- Starting with exterior cladding.
- Laying flooring on upper terraces

2023
Construction Progress
March 2023
March

LOMAS 3: Interior partition walls, interior installations, start of interior carpentry ant start of false ceilings.
LOMAS 4: Concrete structure and facades.

2023
Construction Progress
January 2023
January

The masonry of the facades of Lomas 3 is being completed and the structure of Lomas 4 is being built.

2022
Construction Progress
November 2022
November

The dwellings that make up the development are being raised and the interior installations are beginning to be installed.

2022
Construction Progress
September 2022
September

Work on Lomas 3 and Lomas 4 is progressing well, with the structure of the houses being finalised.

2022
Construction Progress
July 2022
July

We are progressing with the execution of the structure of the first floors of Lomas 3 as well as the pillars and base of Lomas 4.

2022
Construction Progress
May 2022
May

The construction of the Lomas 3 and Lomas 4 housing developments has started and is proceeding according to plan.

LOMAS 5 PROGRESS

Construction progress Lomas 5A
Work in progress 98%
Construction progress Lomas 5B
Work in progress 81%
2026
Construction Progress
January 2026
January

Lomas 5B:

Pre-sale Blocks 4 to 9, final revisions

Installations, partition walls, flooring, carpentry blocks 10 and 11

Gardening in communal areas

Finishing Garages blocks 10 and 11

2025
Construction Progress
November 2025
November

Lomas 5B:

Blocks 4-9
Final stages of the development.

Blocks 10-11
False ceilings.
Painting.
Woodwork.
Kitchenss.

The common areas are also being finished.

2025
Construction Progress
September 2025
September

Lomas 5B:

Blocks 4-5
Sewer connections.
Painting.
Urbanization works.

Blocks 6-7
Sewer connections.
Painting.
Urbanization works.

Blocks 8-9
Sewer connections.
Painting.
Urbanization works.
Installations.

Blocks 10-11
Sewer connections.
Bricklaying and partition walls.
Urbanization works.
Installations.

2025
Construction Progress
July 2025
July

Lomas 5B:

Blocks 4-5
Home repainting.
Kitchen installation.

Blocks 6-7
Roofing installation.
Painting. Kitchens.

Blocks 8-9
Flooring installation.
Painting.

Blocks 10-11
Drywall.
Masonry.
Installations.

2025
Construction Progress
May 2025
May

 Lomas 5A:
- Landscape planting.
- Pre-sale reviews.
-Water contracting.

Lomas 5B:
- House painting in blocks 4 and 5.
- Kitchen assemblies in block 4 & 5.
- Interior partition walls in blocks 6-7 8-9.
- Installations in all blocks.
-Ceilings in blocks 6-7,8-9,10-11.
- Masonry blocks 10 - 11.
- Installation of roofs in blocks 10 and 11.
- Beginning of swimming pool works.
- Starting of works of urbanization connections.

2025
Construction Progress
March 2025
March

 Lomas 5A:
- Finishing construction Works and CFO process.

Lomas 5B:
- Finishing the ceilings of the apartments and painting in B4 and B5.
- Installations of kitchen furniture.
- Bricklaying and partitioning in B6, B7, B8 and B9.
- Finishing roofs in B10 and B11.

2025
Construction Progress
January 2025
January

 Lomas 5A:
- Construction of exterior retaining walls.
- Sanitation connections installed.
- Start of plumbing connection adaptation.
- Kitchen assembly.
- Painting of Blocks 1 and 2.
- Construction of attics.
- Completion of exterior flooring.
- Completion of site adaptation for signing CFO.

Lomas 5B:
- Execution of partitioning and painting in Blocks 4 and 5.
- Masonry and partitioning in Blocks 8 and 9.
- Execution of roofs Blocks 8, 9, 10 and 11.
- Installations in B 6-7-8-9.
- Masonry blocks 10 and 11.
- Plastering in Blocks 4 and 5.

2024
Construction Progress
November 2024
November

 Lomas 5A:
- Execution of penthouses.
- Execution of electricity and drainage connections.
- Installation of kitchens.
- Execution of partition walls in Blocks 1 and 2.
- Finishing of roofs in Blocks 1 and 2.

Lomas 5B:
- Execution of partition walls in Blocks 4 and 5.
- Masonry in Blocks 8 and 9.
- Execution of roofing Blocks 4, 5, 8 and 9.
- Structure of Blocks 6, 7, 8 10 and 11.

2024
Construction Progress
September 2024
September

 Lomas 5A:
- Interior installations of apartments.
- Aluminum carpentry.
- Floors in common areas.
- Partition walls in blocks 1 and 2.
- Partition walls in attics.

Lomas 5B:
- Structures in blocks 6-7, 8-9, 10-11.
- Masonry block 6-7.
- Partition walls block 4-5.
- Installations block 4-5.

2024
Construction Progress
July 2024
July

 Lomas 5A:
- Dwellins’ Instalations (water, electricity, air conditioning, sanitation, ventilation, telecommunications).
- Interior partitioning.
- Exterior carpentry.
- Swimming pool.
- Urbanization’s perimetral wall.
Lomas 5B:
- Roof structure finnishing. (Buildings 4-5)
- Starting of Sanitation Works, Air conditioning and ventilation. (Buildings 4-5)
- Masonry. (Buildings 4-5)
- Making the strutures. (Rest of the Buildings)

2024
Construction Progress
May 2024
May

 Lomas 5A:

- Structure of the buildings.
- Inside masonnry of the dwellings.
- Storage rooms in the garages.
- Downpipes drains.
- Plasterboard partitioning.
- Interior installations.
- Roofs.
Lomas 5B:
- Completion of earthworks.
- Micropiles buildings 10 and 11.
- Foundations and structures buildings 6 – 7 – 8 and 9.
- Inside masonery buildings 4 and 5.

2024
Construction Progress
March 2024
March

 Lomas 5A:

- Structure of the buildings.
- Plumbing.
- Electric installations.
- Masonry on dwellings.
- Storage rooms.
- Sanitary sewer downspouts.
- Deck.
Lomas 5B:
- Completion of earthworks.
- Micropyle foundations.
- Structure of buildings 4 & 5.
- Cementation and structure of buildings 6 & 7.

2024
Construction Progress
January 2024
January

 Lomas 5A:

- Structure of the buildings.
- Masonry on dwellings.
- Storage rooms.
- Sanitary sewer downspouts.
Lomas 5B:
- Completion of earthworks.
- Micropyle foundations.
- Cementation and structure of buildings B4 & B5.

2023
Construction Progress
November 2023
November

 Lomas 5A:
- Structure of the buildings
Lomas 5B:
- Completion of earthworks
- Foundations

2023
Construction Progress
September 2023
September

- Start of foundations.
- Start of structures.

2023
Construction Progress
July 2023
July

- Earthworks
- Start of the building’s foundations

Utilizamos cookies propias y de terceros para personalizar el contenido de la web, proporcionarles funcionalidades a las redes sociales y analizar el tráfico de nuestra web. Puede aceptar el uso de esta tecnología o administrar su configuración y poder rechazarla, y así controlar completamente qué información se recopila y gestiona a través de los botones habilitados al efecto. Al clicar en Sí, Acepto, ACEPTA SU USO, si bien podrá retirar su consentimiento en cualquier momento. También puede RECHAZAR la instalación de cookies clicando en No Acepto o CONFIGURAR la instalación de cookies clicando en Configurar Cookies.  Para obtener más información al respecto, puedes consultar nuestra Política de Cookies. Para obtener información sobre nuestras políticas de datos, visite nuestra Política de privacidad.    Configurar
